Kitchen Remodeling Los Angeles: Permits, Problems and Timelines

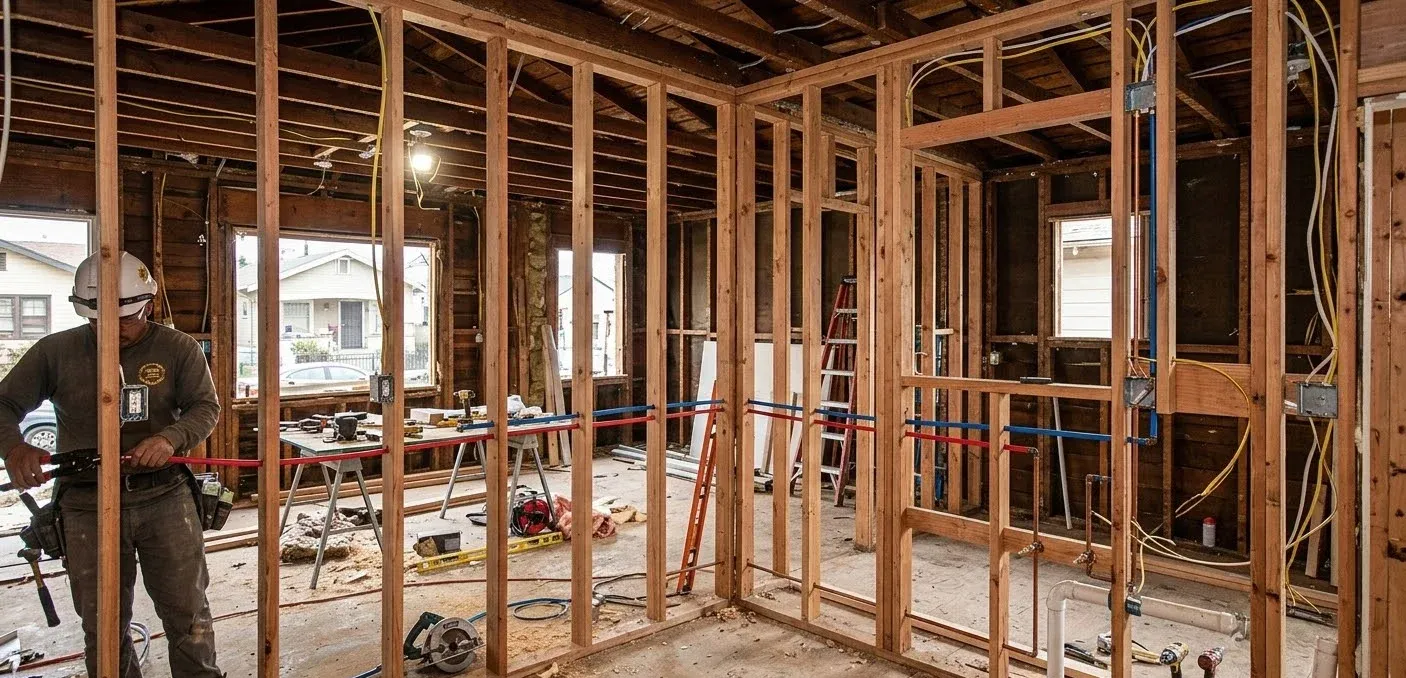

A gutted kitchen in an older one-story wood-framed house, with the cabinets removed, one wall opened to bare studs, two temporary shoring walls holding up

Key Takeaways

  • You need a permit once you move or add plumbing, gas, wiring or walls. Removing a wall or changing the structure moves the job out of the Express Permit and into plan check.
  • In older homes, demolition often finds rot, termite damage or failing pipes. Those finds can change the permit, the engineering and the schedule.
  • The building department sets review times and inspection dates. Plan for design, permits, ordering, asbestos and lead testing, and utility work, not just construction.

Most kitchen remodeling Los Angeles projects need a permit once you move plumbing, gas, wiring or walls. How long the job takes depends on what the city requires and on what you find behind the old cabinets. A same-layout swap of cabinets and counters may not need one. The real risk is in older houses, where demolition often turns up soft framing or failing pipes that change both the permit and the plan.

Which kitchen remodeling Los Angeles jobs need a permit or plan check?

You need a permit when you move or add plumbing, gas, electrical or walls. In the City of Los Angeles, a kitchen remodel with no structural changes can usually use the faster Express Permit, while removing or changing a wall sends it to plan check.

An Express Permit is a permit the city issues without a plan review, often online. Plan check is the full review, where a city plan checker reads your drawings and sends back corrections before the permit is issued. The LADBS Express Permit information bulletin lists residential kitchen remodels with no structural changes as Express Permit work, along with adding plumbing fixtures.

First, confirm which building department you deal with. LADBS covers only the City of Los Angeles. Unincorporated areas go through LA County Public Works, and every other city runs its own building department. A Los Angeles mailing address doesn’t settle it, so look up the parcel.

For property inside the city, the ZIMAS parcel map shows whether your lot sits in a hillside area, a fire zone or a historic preservation overlay. An overlay is an extra set of rules on top of the normal ones, and it can add review steps. For the full list of trade permits, see our guide on what permits a kitchen remodel needs.

If tenants live in the unit, the city housing department has its own rules for when a kitchen is out of service. Sort that out before demolition.

What happens if demolition uncovers rot, termites or a load-bearing wall?

Work stops at that spot until the right repair is decided, and the permit may need to change. Rotted or termite-damaged framing usually gets replaced or reinforced. A load-bearing wall you want to remove needs an engineered beam and plan check.

A load-bearing wall carries weight from the floor or roof above. The sill plate is the wood board that sits on top of the foundation. In older Los Angeles homes, the wall behind the sink often hides a soft bottom plate and darkened subfloor from years of slow drips at the trap or dishwasher hose. Termites like that damp corner too.

Our approach is simple: find the real cause, then recommend the safest targeted repair the city will accept. That might mean replacing one rotted plate and a few stud ends instead of the whole wall. But if you fix the wood and don’t stop the leak, the damage comes back.

Removing a load-bearing wall means a licensed engineer designs the beam, the posts that hold it up, and the support under those posts. A new post puts a lot of weight on one small spot, so it often needs a new footing. Temporary shoring walls hold up the ceiling while the old wall comes out.

If the repair changes the structure, an Express Permit job can move into plan check. That adds engineering and review time, and the city building department decides how long review takes. Our article on managing kitchen permit revisions explains how those changes get filed.

A gutted kitchen wall below a window in an older one-story wood house, with drywall cut away to show a dark, crumbling bottom plate and

What if the drain lines or galvanized pipes behind the kitchen walls are failing?

Replace them while the walls are open, because you won't get an easier chance. New drain, vent and water piping is permitted plumbing work, and the inspector checks it before the walls close.

Galvanized pipe is steel water pipe coated with zinc, common in houses built before the 1960s. It rusts closed from the inside, so you see weak pressure or brown water. Cast iron is the heavy black drain pipe in older homes. Under raised Los Angeles houses, it often cracks along the bottom where water sits.

Warning signs include slow drains that come back after snaking, a sewer smell under the sink, ceiling stains below a second-floor kitchen, and pipe that flakes when touched. Drain, waste and vent lines, or DWV, carry used water out and let air in so drains flow freely. A new faucet on an old, failing drain isn’t a repair.

A typical sequence looks like this:

  1. Open the wall and expose the full run of pipe.
  2. Trace how far back the bad pipe goes.
  3. Install the new drain, vent and supply lines.
  4. Test the drains and pressure-test the supply lines.
  5. Get the rough plumbing inspection before insulation and drywall go up.
An opened interior kitchen wall in an older two-story house, showing a rusty cast-iron drain stack with a long crack down its side next to

Can you move the sink to an island or change the kitchen layout?

Usually yes, but the drain and the vent decide how hard it is. An island sink needs a drain with a steady downhill slope and a way to vent without a wall behind it, which often means opening the floor.

A vent is a pipe that lets air into the drain so water flows smoothly and the trap doesn’t get sucked dry. Against a wall, the vent runs up inside the wall. An island has no wall, so the plumber has to use a venting method the inspector will accept.

On a raised wood floor, the new drain can run through the crawl space. On a concrete slab, the slab gets cut and trenched for a sloped drain, then patched. A long run can drop so much that it ends up below the main line before it reaches it.

Moving one thing usually moves others: power and a drain for the dishwasher, a new gas or electrical line for the range, a duct path for the hood. Our guide on how to plan a kitchen remodel walks through the order of those decisions. Settle the drain before cabinets are ordered.

Will moving the range or switching to induction require gas or electrical upgrades?

It can. Moving a gas range needs a permit and a pressure test, and an induction cooktop needs a dedicated circuit that an older electrical panel may not be able to handle.

Gas line work is permitted. Once the new pipe is in, it gets a pressure test: the line is sealed and filled with air to prove it holds, and the city inspector checks it. If the meter or service needs to change, SoCalGas has to be part of the schedule, on its own timing.

Induction uses a magnetic field to heat the pan directly, and it needs a large dedicated circuit. Add circuits for a microwave and dishwasher, and an older panel can run out of room. If the service wire from the street also has to get bigger, your utility, LADWP or SCE depending on where you live, approves and schedules that work on its calendar.

Lighting has its own rules. Under the 2025 California Energy Code, new or altered lighting has to comply. Kitchens need easy-to-reach wall dimmers, and under-cabinet lights must be switched separately from ceiling lights. Put those on the plans before rough wiring.

Gas or induction is your call. On any kitchen remodeling Los Angeles job, find out early what the panel, gas line and service can handle.

Does an older house need asbestos and lead testing before demolition?

Often, yes. The rules depend on how much material gets disturbed and who does the work, not only on the age of the house. The South Coast AQMD sets the asbestos survey rules, and the EPA sets the lead-safe rules for older homes.

Asbestos is a mineral fiber once used in flooring, the black glue under old tile, joint compound and pipe wrap. It’s harmless left alone and dangerous as dust. The South Coast AQMD asbestos compliance advisory says a survey must be done and documented before renovation begins, except in a single-unit house where less than 100 square feet of asbestos material is removed.

The homeowner exemption is narrow. The legal owner has to live in the single-family house and do the work personally, with no contractor or helpers. Condo, townhouse and apartment owners don’t get it, and the district doesn’t recommend homeowners remove asbestos themselves.

Under the EPA lead renovation, repair and painting program, anyone paid to disturb paint in a house built before 1978 must work for a lead-safe certified firm, including plumbers and electricians. The firm gives you the Renovate Right pamphlet, seals off the area with plastic, and cleans up in a way that traps the dust. The rule generally doesn’t cover owners working on their own homes, but it does cover rentals.

Test before demolition. Older kitchens often have two or three layers of flooring, and the bottom one is usually the concern.

How long does a kitchen remodel take, and which inspections happen in what order?

It depends on design, permit review, ordering lead times and what demolition finds. The city building department controls permit review and inspection dates, so no contractor can promise them. Schedules that seem to disagree are often measuring different things.

If one company quotes weeks and another quotes months, ask what each covers. Some count construction only; others include design, engineering, permits and cabinet lead times. A complete schedule moves through these phases:

  1. Measurements, layout and scope.
  2. Engineering, if the structure changes.
  3. Permit: an Express Permit, or plan check with corrections.
  4. Ordering cabinets and appliances.
  5. Demolition, testing and repairs to hidden damage.
  6. Rough framing, plumbing, gas and electrical.
  7. Inspections, finish work and the final inspection.

Inspections follow the work as it’s built, though your building department may combine or add steps:

  1. Rough framing, when walls or beams change.
  2. Rough plumbing, including the drain test.
  3. Rough electrical.
  4. Gas pressure test.
  5. Insulation and drywall nailing, where required.
  6. Final, after fixtures and appliances are in.

Build in slack. A failed inspection means a fix and a re-visit, and cabinets that arrive before the permit sit in your garage.

What does the cost of a kitchen remodel with structural or plumbing problems depend on?

It depends mostly on what's behind the walls and under the floor, so an honest number has to wait until someone looks. Moving walls, replacing pipe and upgrading utilities drive the cost far more than finishes do, and the final number needs a site visit.

The biggest cost drivers are structural and mechanical:

  • Whether a wall comes out and the beam needs new footings.
  • How much framing is rotted or termite-damaged.
  • How far the failing pipe runs, and whether the floor is wood or slab.
  • Whether the panel or utility service needs upgrading.
  • Whether asbestos or lead work is needed.
  • Whether the job stays on an Express Permit or goes to plan check.

On older kitchen remodeling Los Angeles jobs, something usually turns up once the cabinets come off, so keep a reserve. Ask for an itemized scope that separates known work from allowances for unknown conditions. Our article on how much a kitchen remodel costs explains how estimates are built.

How do you check that a contractor can legally do this work?

Look up the license on the CSLB website before you sign, and confirm it's active and covers the work. Then make sure the contract says who pulls permits and how hidden-damage changes get approved.

The Contractors State License Board license lookup shows whether a license is active, its classification, and its bond and workers’ compensation status. A general building license covers a remodel involving more than one trade.

A licensed contractor normally pulls the permit under their own license. If you’re asked to pull an owner-builder permit, you take on responsibility for the work and inspections.

A solid contract spells out:

  • The full scope of work.
  • Who handles permits and inspections.
  • Payments tied to completed work.
  • How change orders for hidden damage are priced and approved in writing.
  • Who arranges asbestos and lead testing, and lead-safe certification when the house is old enough to need it.

Villa Bella Construction is licensed and insured and focuses on kitchen remodels with structural or plumbing problems, from rotted framing under the sink to wall removals and drain replacement.

When should you call a licensed contractor about your kitchen remodel?

Call before demolition if your house is older, if you want to move the sink or take out a wall, or if you see warning signs: a soft floor in front of the sink, slow drains that keep coming back, rusty water, or breakers that trip when two appliances run. If demolition has started and you’ve found rot, termite damage or cracked pipe, stop work in that area and have it looked at before anything gets covered. A site visit can sort out what’s cosmetic, what needs a permit, and what needs an engineer.

“Steve was easy to work with and was very responsive.” — Bill M., Yelp review

Villa Bella Construction is a licensed and insured general contractor, building in Los Angeles for 25 years. CSLB License #1093648 (B – General Building).

Call +1 (323) 825-9798 or send us your project details.

Learn more: Kitchen remodels with structural or plumbing problems.

Written by Villa Bella Construction. Licensed and insured general contractor in Los Angeles. CSLB License #1093648 (B – General Building).
